Public Discussions about Kelowna Development Projects
Do they have the pool deck done yet?
Movala Phase II will be completed and ready for move in by end of August to early September!
Jack B |construction update at Okanagan Gondola
Urban Legend, Jul 14, 2026
Kelowna Developments about 1333 Bertram St
Observer, Jul 14, 2026

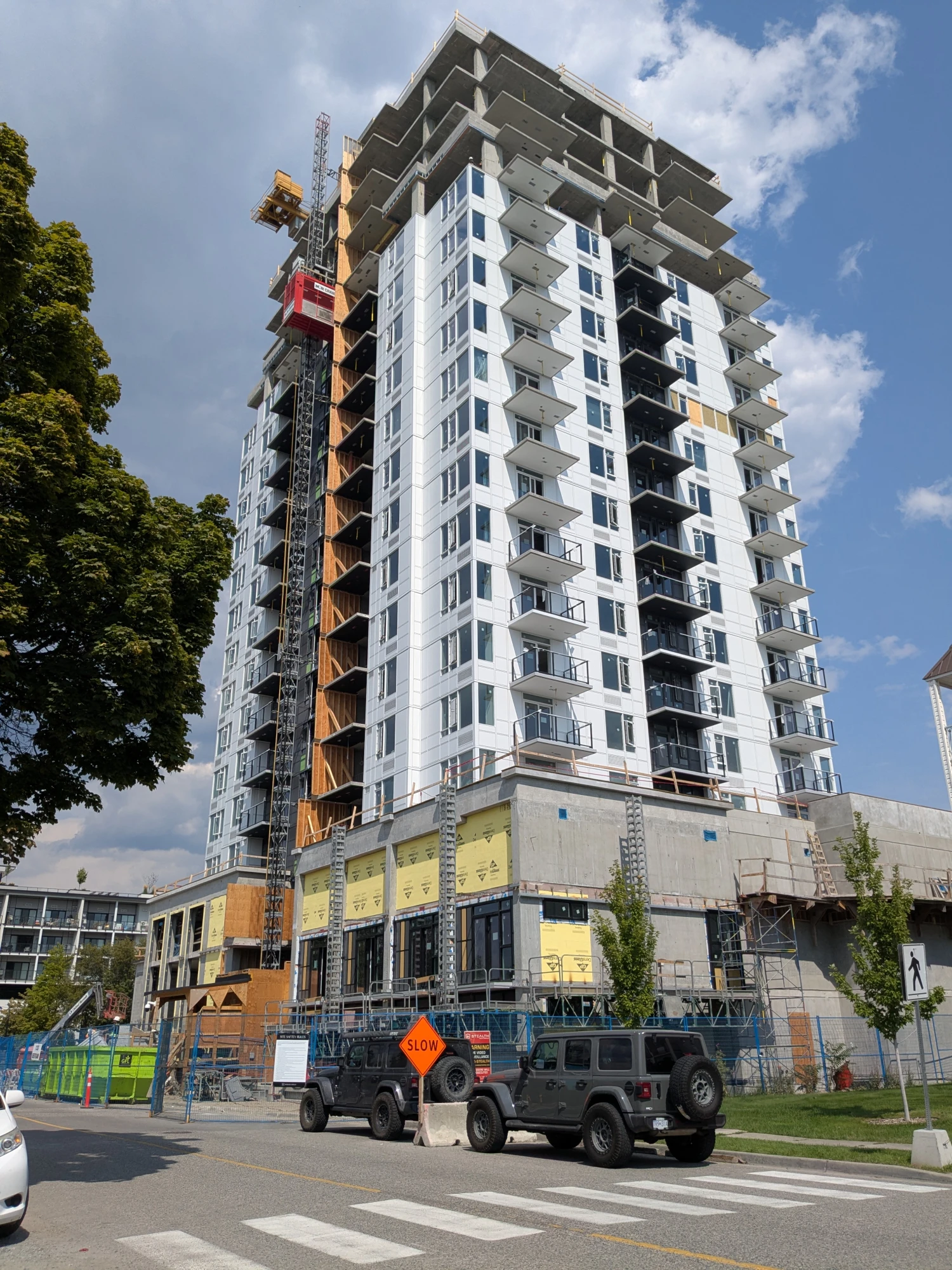

1333 Bertram will be ready for move-in in August 2026 according to Mission Group.
Movala Phase II will be completed and ready for move in by end of August to early September!
Kelowna Developments about UBCO Downtown
Observer, Jul 13, 2026
The development really hasn’t changed for the past month. We’re looking at mid September for 8th floor completion, then roughly 1 floor per week from there. If things go smoothly, we can possibly see 8th floor completion by end August to early September, then we will finally see the climb to 43 storeys.
Gary Jones about Okanagan Gondola
Newcomer, Jul 10, 2026
Having lived in the Okanagan for fourteen years, the best years of my life, truly a four season playground, I am a little confused by this project. The promo video shows the camera wandering around what looks like a paved road but not much more. A hundred million dollars for a gondola to a restaurant? Having hiked and dirt biked all around the area you can get great views for free. Not sure that locals or visitors are going to see the attraction.
Jack B about 1448 Gordon
Urban Legend, Jul 08, 2026
They are gonna have the vehicle elevator to access the parking. First of it's kind in residential development in Kelowna.
https://www.castanet.net/news/Kelowna/621202/Ne...
Jack B |construction update at Sutton Place
Urban Legend, Jul 08, 2026
Sheener about Vivo
Local Expert, Jun 30, 2026
construction fencing is up and demolition of single-detached homes currently on the site is well underway
Anonymous about Bertram BC Housing
Newcomer, Jun 27, 2026
Insider: Project has been unofficially terminated by the provincial government.
Kelowna Developments about UBCO Downtown
Observer, Jun 18, 2026
The first 8 floors are different, which is why it is taking so long. First 8 floors will take approximately 3 - 4 weeks each, then from 9th floor onward, we can see around one floor per week, so there will definitely be more than 11 by the end of the year.
Current rate puts it at 11 stories by year's end with 32 to go
Derek about UBCO Downtown
Newcomer, Jun 17, 2026
Current rate puts it at 11 stories by year's end with 32 to go
Anthony P |construction update at UBCO Downtown
Community Voice, Jun 17, 2026
Jack B about UBCO Downtown
Urban Legend, Jun 05, 2026
Haha.
New drinking game! Take a shot every time a new floor gets finished, might take awhile tho…
Glad to see the steady progress on this build
Okanagan Enthusiast about UBCO Downtown
Community Voice, Jun 04, 2026
New drinking game! Take a shot every time a new floor gets finished, might take awhile tho…
Glad to see the steady progress on this build
Making slow progress. Just started with 5th floor. Hopefully makes progress to skyline by mid summer.
